User guide

Project screens

Dashboard shows the overview, Plan the work and materials, Budget the money and Timeline the dates. All four are in the app’s bottom menu.

Dashboard

A quick renovation overview: the project’s main screen, or dashboard.

Practice project dashboard: target 5 000, plan 4 000 and paid 800.
Practice project dashboard: target 5 000, plan 4 000 and paid 800. Enlarge
Plan / Fact
Choose the calculation basis. For unpaid items, the project’s “Fact” total still uses planned amounts.
Main totals and budget usage
Show the selected mode’s budget, already paid and remaining. The target budget is displayed separately.
Item completion
Work progress. It does not confirm payment.
Stage progress and breakdowns by stage and tag
Help identify where costs are concentrated and what is done. Scroll down the Dashboard; check the mode and selected stages.

To check a particular work item, open “Plan”.

Plan

The main list of renovation stages, work and materials.

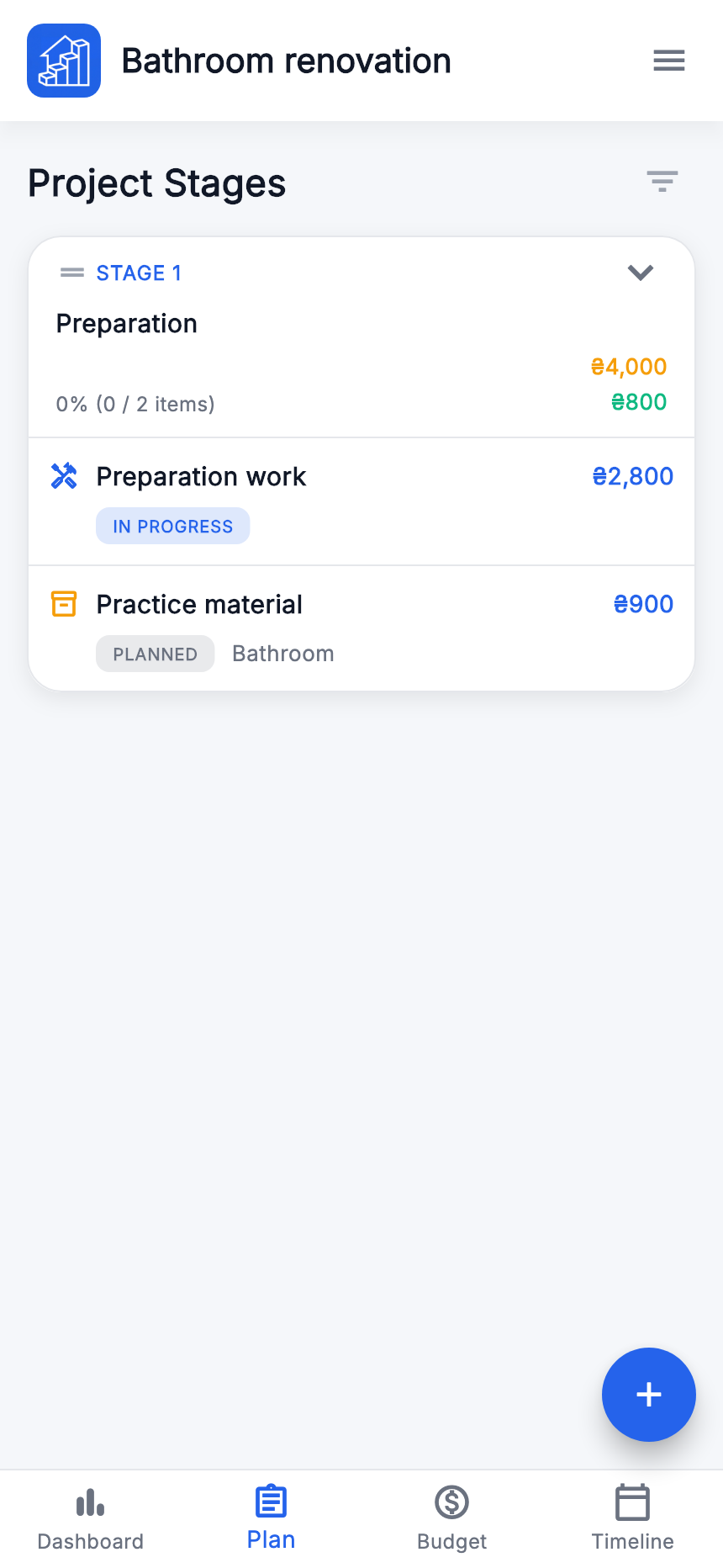

Plan: the “Preparation” stage with our work and material items.
Plan: the “Preparation” stage with our work and material items. Enlarge
  1. Check the active project name at the top.
  2. Expand a stage with its arrow to see the items.
  3. Open an item to view it, then edit. Use “+” to add a stage or item.

If an item is missing, check whether its stage is expanded or filters are active. Confirm the correct renovation is open before creating a duplicate.

Budget

Check planned amounts, payments, prepayments and discounts here.

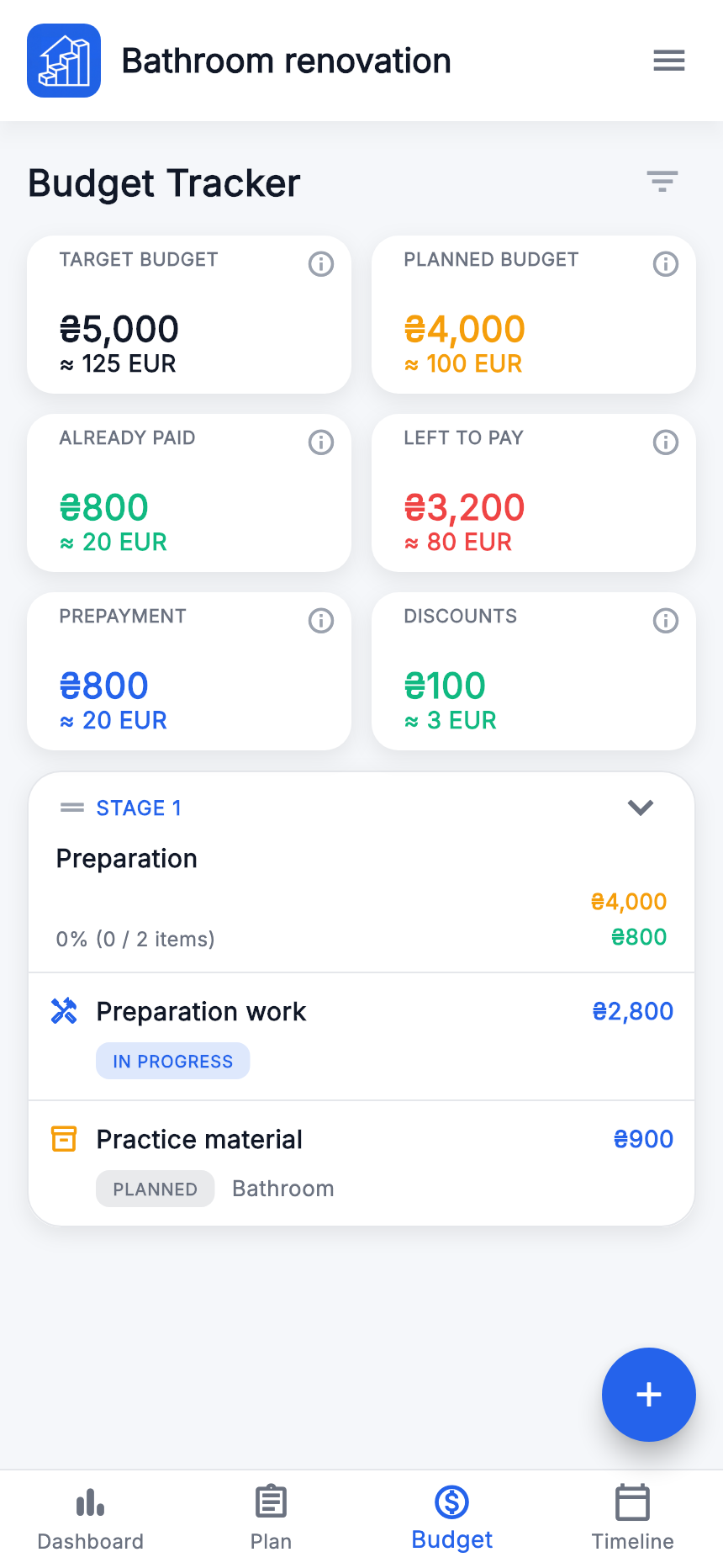

Budget for the same project: plan 4 000, paid 800 and planned remaining 3 200.
Budget for the same project: plan 4 000, paid 800 and planned remaining 3 200. Enlarge
Target Budget
The chosen renovation limit: UAH 5 000.
Plan
The total planned costs of included items: UAH 4 000.
Fact on the Dashboard
Uses the planned amount for an unpaid item and the final fact amount for a fully paid one.
Already paid
Prepayments on unpaid items plus full fact amounts on paid items.
Remaining
The selected mode’s budget minus already paid. On the Budget page, “Remaining to pay” uses the planned basis, like “Remaining (plan)” on the Dashboard.

Before and after full payment of the work

There are two items: work with plan 3 000, price 2 800 and prepayment 800; material with plan 1 000 and price 900, still unpaid. All amounts below are in Ukrainian hryvnias.

Whole practice-project totals, without filters
MeasureBefore paying the workWork paid in full
Plan4 0004 000
Fact4 0003 800
Already paid8002 800
Remaining (Fact)3 2001 000
Remaining (plan)3 2001 200

For the second results column, enable “Paid” for the work item only and save it. The material remains unpaid, so “Fact” still includes its 1 000 planned amount.

Before paying the work, the balance against recorded final prices is 2 800 + 900 − 800 = UAH 2 900. This differs from “Fact” remaining, which uses planned amounts for unpaid items. Compare matching modes and filters.

Timeline

A calendar view of stage dates.

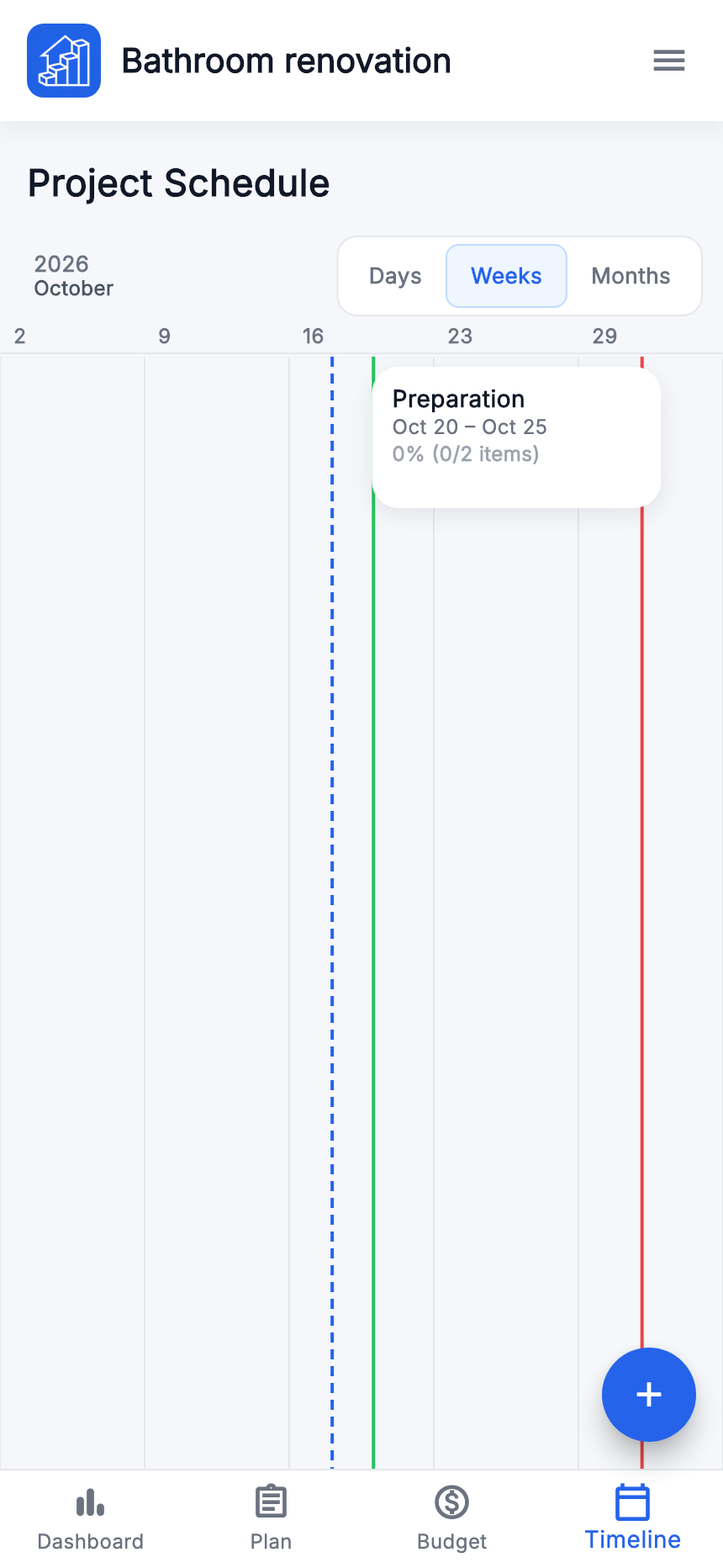

“Preparation” stage schedule: 20–25 October 2026.
“Preparation” stage schedule: 20–25 October 2026. Enlarge
  1. Open “Timeline” in the bottom menu.
  2. Choose “Days”, “Weeks” or “Months”.
  3. Find the stage and compare its dates with others. Edit the corresponding stage to change its dates.

Missing dates give an incomplete schedule. Our project runs from 20 October to 2 November; the stage runs 20–25 October. Stage completion depends on item completion.
